North Sydney Pool Opening Slides to Early 2026 Amid New Delays

Written by News Aggregator

North Sydney Pool Opening Slides to Early 2026 Amid New Delays

NORTH SYDNEY/Sunday 09 November,2025

News article generated and fomatted with Goolge Gemini AI /Fact checking A.Ritenis



—Local swimmers face another summer on the sidelines as the reopening of the iconic North Sydney Olympic Pool has been pushed back yet again, with the facility now not expected to welcome the public until the first quarter of 2026.

The project, which began in 2021 with an original budget of approximately $64 million and an expected 2022 completion, has been plagued by program slippages, design issues, and extensive contractual claims, driving the total forecast cost to completion to a staggering $122 million.

Timeline Blowout Confirmed

According to recent reports presented to North Sydney Council, contractor Icon is now forecasting practical completion—the stage where the site is formally handed over to Council—for November 18, 2025.

This date is nearly 16 months later than the original contractual completion deadline of July 11, 2024.

Council officials have confirmed that after handover, an additional two to three months are required for facility commissioning, staff training, and operational readiness. This final step pushes the likely public reopening into the new year, effectively missing a third consecutive summer season.

Causes of the Protracted Delay

The redevelopment, which includes a new 970-seat grandstand, a 50m outdoor pool, a 25m indoor pool, and a wellness centre, has faced a confluence of complex issues:

  • Design and Latent Conditions: Early in the process, structural flaws necessitated the disassembly and removal of the newly built steel roof framing over the 25-metre indoor pool, an event that triggered major delays and increased complexity.
  • Contractual Disputes: Contractor Icon has lodged over 540 variation claims and nearly 160 Extension of Time (EoT) claims, along with 1,855 Requests for Information (RFIs), placing continuous pressure on the project’s schedule and budget.
  • External Factors: Initial phases of the project were compounded by COVID-19 related supply chain disruptions and extended periods of wet weather.

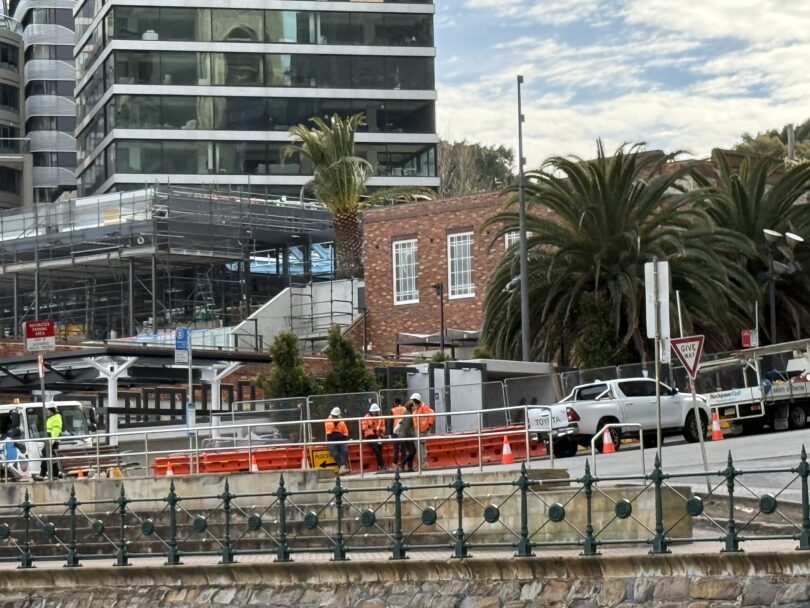

North Sydney Council Chambers ,Miller Street ,North Sydney

Financial Crisis and Rejected Rate Hike

The escalating timeline and cost overruns—which saw the budget balloon from $64 million to a forecast $122 million—have plunged North Sydney Council into a severe financial crisis.

The Council sought a Special Rate Variation (SRV) from the state regulator to repair its liquidity and fund the massive blowout. This application proposed a cumulative 87.05% rate increase over two years, sparking fierce backlash and widespread community protests from residents unwilling to shoulder the burden of the project’s mismanagement.

However, the Independent Pricing and Regulatory Tribunal (IPART) delivered a major setback in May 2025, officially rejecting the Council’s SRV application. This decision leaves a significant funding gap for both the pool and other critical infrastructure renewals.

North Sydney Council is now forced to conduct a full review of all services and programs, prioritizing expenditure and service cuts to restore financial sustainability, even as the pool remains unfinished.

Despite the ongoing delays, Council documents suggest that on-site momentum has improved in recent weeks, with builders focused on final elements such as tiling the leisure pools, fitting out change rooms, completing grandstand glazing, and finishing the major mechanical plant room systems.

The facility, when finally completed, is set to offer state-of-the-art amenities, including a 50-metre pool, a family leisure pool, spa and sauna facilities, a 1,100m² gym, a crèche, and the reconstruction of the former Ripples Café. However, the extended wait time and spiraling costs continue to be a source of frustration for the North Sydney community.

_____________________________________________________________________

***Stop Press

Latest updates

Council’s contractor, ICON, is now reporting that the pool construction will be complete by 4 December 2025. Once the completed facility is handed over to Council, we will need to commission and prepare the site for opening, which will take up to 3 months.

Our priority remains delivering a first-class facility that meets the needs of the community and we will continue to keep you updated.

Readers can  sign up for the North Sydney Olympic Pool e-newsletters for all the latest information or see the timeline of works page.
